Botswana: Tlou Energy completes drilling of first development pod at its Lesedi CBM project in Botswana


12 Feb 2019

Photo - see caption

Tlou Energy has successfully completed the drilling of the Lesedi 3 development pod at its CBM project in Botswana.

Highlights

  • Lateral wells Lesedi 3A and Lesedi 3B have been successfully completed with both wells intersecting with the vertical well Lesedi 3P to complete the Lesedi 3 development pod.
  • Dewatering and gas flow testing at Lesedi 3 will commence following the installation of production equipment.
  • The drill rig is being moved to the second planned production pod, Lesedi 4.
Photo - see caption

Pilot well drilling program

The Company commenced drilling of development wells at its gas field in late 2018.  The wells are being drilled as 'dual lateral pods', comprising a single vertical production well intersected by two lateral wells.  The lateral wells are being drilled through the gassy coal seam with gas extracted from this coal produced through the vertical production well where it can be gathered and used for power generation.  Pod One is designated 'Lesedi 3' and comprises a vertical production well ('Lesedi 3P') and two lateral wells ('Lesedi 3A' & 'Lesedi 3B').  Pod Two is designated 'Lesedi 4',

The Company can confirm that drilling operations at Lesedi 3 have been completed.  Lateral well Lesedi 3A was drilled ~1,437m Measured Depth (MD) and Lesedi 3B was drilled ~1,440m MD with both lateral wells successfully intersecting with vertical well Lesedi 3P to complete the dual lateral pod.

Lesedi 3 is now being prepared for installation of production facilities prior to the commencement of de-watering and lowering of the pressure in the coal seam to achieve gas flow.

Photo - see caption

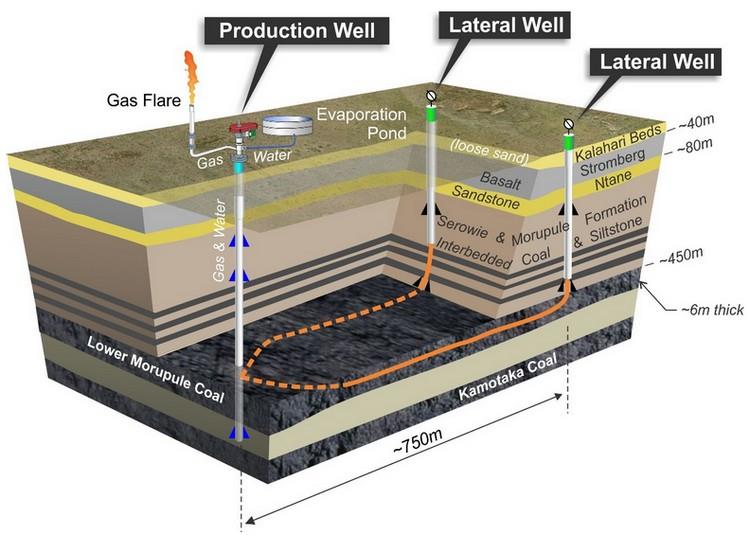

Horizontal Pilot Well Schematic

The drilling rig is being moved to commence drilling of the second planned development pod, Lesedi 4. The Company will provide further updates as the drilling operations progress.

The development drilling program is being conducted in accordance with health and safety requirements and are consistent with the Company's approved environmental impact statement.  If results are positive, these wells will form part of the Company's initial gas-to-power project which will include installation of transmission lines and grid connection.

Original article link

Source: Tlou Energy





Bookmark and Share


A global information service for upstream oil and gas opportunities - divestitures, farmins and farmouts and licensing rounds.


Subscriber Only Deals

Current deals: 1664
Completed deals: 5100

Company Profiles

Current Company Profiles: 2625

Corporate Activity

Current Corporate Activity articles: 3181

Companies Looking

Current number of articles: 424

Company Sales

Current Company Sales articles:1318

Geostudies

Current Geostudies articles: 613

How to subscribe

energy-pedia Jobs

RSS Feed Widget
See all jobs...


energy-pedia Databank

The energy-pedia databank contains links to information on the world financial and energy markets, including share prices, oil and gas prices and the global stock exchanges. Read more...



energy-pedia Glossary

A list of commonly used terms in the oil and gas industry. Read more...

Subscribe

Subscribe to the FREE
energy-pedia Daily Newsletter
Subscribe

count geophysics
energy365
EP Consult Energies
Union Jack Oil 149
OPC
Lynx Information Systems
KL Publishing
RSK Logo 149
Bayphase
Rose & Assocs 149
SLR Consulting logo
Government of South Australia
About energy-pedia

energy-pedia news is a FREE news service written and edited by E and P professionals for E and P professionals.

We don't just report the news, we give you the technical background as well, with additional information derived from our unique energy-pedia opportunities service.
Contact us

energy365 Ltd

238 High Street
London Colney
St Albans
UNITED KINGDOM

Tel: +44(0)1727 822675

Email: info@energy-pedia.com
