Botswana: Tlou Energy announces quarterly activity report


28 Apr 2023

Photo - see caption

Tlou Energy, developing power solutions for Botswana through gas-fired power and ancillary projects, has announced a quarterly activity report.

Highlights

  • The 66KV overhead transmission line is steadily progressing
  • Development of a purpose-built operations facility is continuing
  • Substation construction scheduled to commence
  • Production well drilling underway with Lesedi 6

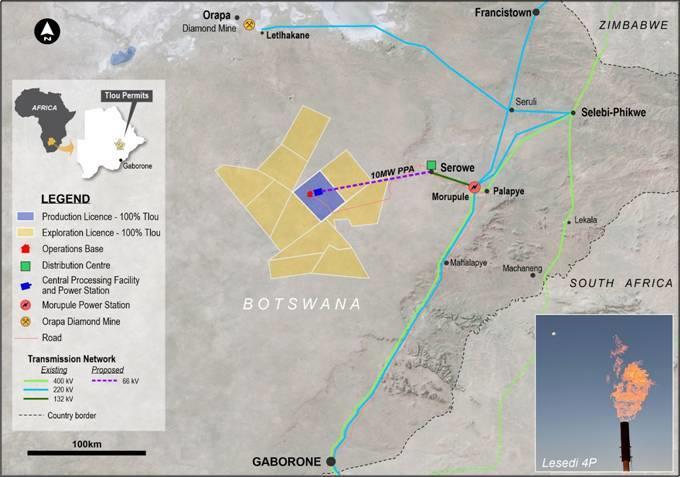

Photo - see caption

Activities

Tlou Energy continues to have three key project areas referred to as:

  • Lesedi Project - focused on the development of gas to power development as well as exploration and evaluation.
  • Mamba Project - focused on exploration and evaluation.
  • Boomslang Project - focused on exploration and evaluation.

Lesedi Project

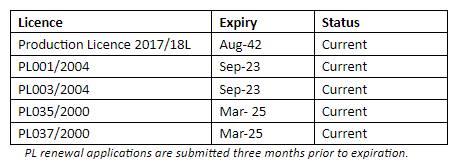

The Lesedi project is Tlou's most advanced. It is currently developing a 10MW gas to power project. The Lesedi project area has four Prospecting Licenses (PL) and a Production Licence which is the key focus area for the development of Tlou's independently certified gas reserves and contingent resources. All licences held under this project area are valid. The table below summarises the status of the licences:

Photo - see caption

Tlou Energy's initial 10MW Power Purchase Agreement (PPA) is part of a 100MW Request for Proposal for the development of CBM power projects in Botswana. Tlou previously responded to a separate request for proposal for the supply and delivery of natural gas to the Orapa power plant in Botswana. The Company's proposal was not successful.

Gas to Power Project

The first electricity to be generated at Lesedi, will go towards satisfying the 10MW PPA with Botswana Power Corporation (BPC) the national power utility. Tlou is among the first independent power producers to secure a power purchase agreement with the utility.

To this end, the Lesedi project currently has several parts of the development process underway including the construction of transmission lines, substations, a field operations facility and generation site as well as production well drilling.

Transmission Line Construction

The Lesedi project is approximately 100km from the nearest BPC substation connection in Serowe. In efforts to connect onto the national grid, the Company is undergoing the construction and installation of a 100km 66kV transmission line. This, together with the ongoing drilling program can enable the Company to connect and provide electricity into Botswana's power network.

The construction of the 66kV transmission line is being carried out by Zismo Engineering Pty Ltd (Zismo) and is expected to be completed around mid-2023. Zismo is a local engineering procurement construction company that specialises in industrial engineering. Progress to end of March 2023 was estimated at approximately 64%, with planting of wooden poles almost complete, steel pole structures now being erected and over 20km of line stringing complete.

Substation Construction

Substations are required at either end of the transmission line, one to tie Tlou's generators to the transmission line at Lesedi and another to integrate the line with the existing BPC substation at Serowe. This work will be led by South African based OptiPower, a division of Murray & Roberts Ltd. The pre-construction and design works have been completed and physical construction of the substations is scheduled to begin very soon with the project anticipated to be completed in early 2024.

Lesedi Operations Facility

Work has advanced on a purpose-built operations facility for the initial 10MW development and to allow for project expansion thereafter. This project is being undertaken by Tlou through its consultant contractor African Gas Services (AGS).

Drilling and Gas production

The Lesedi 4 production pod continues to produce gas. A key focus in the coming year is to drill more production wells for the 10MW project.

Post quarter end, the Company began drilling the Lesedi 6 production pod. Lesedi 6 is planned to be the first of a series of new pods, funds permitting, that the Company will drill as part of the 10MW gas to power project. Lesedi 6 will comprise one vertical production well intersected by two lateral wells drilled horizontally through the target reservoir section for several hundred metres.

Mamba Project

The Mamba project is in the exploration and evaluation phase with further operations required on the operating licences. It consists of five PL's covering an area of approximately 4,500 Km2. The Mamba area is situated adjacent to Lesedi. In the event of successful drilling results at Mamba, it is envisioned that this area would be developed as a separate project from Lesedi. The Mamba area provides the Company with flexibility and optionality.

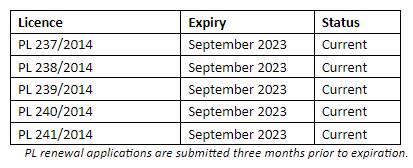

The status of the Mamba licences is as follows:

Photo - see caption

Boomslang Project

Prospecting Licence, PL011/2019 designated "Boomslang", is approximately 1,000 Km2 and is situated adjacent to the Company's existing licences. To date, the Company has not carried out ground operations in the Boomslang area. The status of the Boomslang licence is as follows:

Photo - see caption

Cash Position

At the end of the quarter the Company had ~A$3.54m cash on hand (unaudited). The aggregate value of payments to related parties and their associates of A$339k for the quarter (shown in item 6.1 of the attached Quarterly Cashflow Report) relates to directors' salaries and fees (including tax and superannuation payments made on their behalf) and office rent.

The Company is significantly advanced in relation to raising further capital. In addition, Dr Ian Campbell (Tlou's largest shareholder) has offered a $2m loan to the Company if required. The exact terms of the loan are being finalised. Subject to any regulatory approval the agreement is expected to be signed in the coming days. Once the agreement is executed the funds will be available to draw down immediately if necessary.

Original article link

Source: Tlou Energy





Bookmark and Share


A global information service for upstream oil and gas opportunities - divestitures, farmins and farmouts and licensing rounds.


Subscriber Only Deals

Current Deals

Current Upstream Deals: 195

Completed Deals

Completed Upstream Deals: 6640

Company Profiles

Current Company Profiles: 2932

Corporate Activity

Current Corporate Activity articles: 4197

Companies Looking

Current number of articles: 466

Company Sales

Current Company Sales articles:1674

Geostudies

Current Geostudies articles: 1003

How to subscribe

energy-pedia Jobs

RSS Feed Widget
See all jobs...


energy-pedia Databank

The energy-pedia databank contains links to information on the world financial and energy markets, including share prices, oil and gas prices and the global stock exchanges. Read more...



energy-pedia Glossary

A list of commonly used terms in the oil and gas industry. Read more...

Subscribe

Subscribe to the FREE
energy-pedia Daily Newsletter
Subscribe

Rose & Assocs
Bayphase
Union Jack Oil 149
Merlin
OPC
Telos NRG
energy365
Borchwix
Syntillica
About energy-pedia

energy-pedia news is a FREE news service written and edited by E and P professionals for E and P professionals.

We don't just report the news, we give you the technical background as well, with additional information derived from our unique energy-pedia opportunities service.
Contact us

energy365 Ltd

238 High Street
London Colney
St Albans
UNITED KINGDOM

Tel: +44(0)1727 822675

Email: info@energy-pedia.com
