UK: Vattenfall completes lower-carbon foundations at Clashindarroch II wind farm


05 Oct 2026

  • All 14 turbine foundations completed in an 11-week programme
  • 1,190 tonnes of recycled reinforcing steel used — equivalent to the weight of 826 cars(6)
  • 11,256m³ of lower-carbon concrete used, cutting embodied carbon by an estimated 20–30% per cubic metre(5)
  • On-site concrete production reduced long-distance deliveries, traffic movements and associated emissions(4)
Photo - see caption

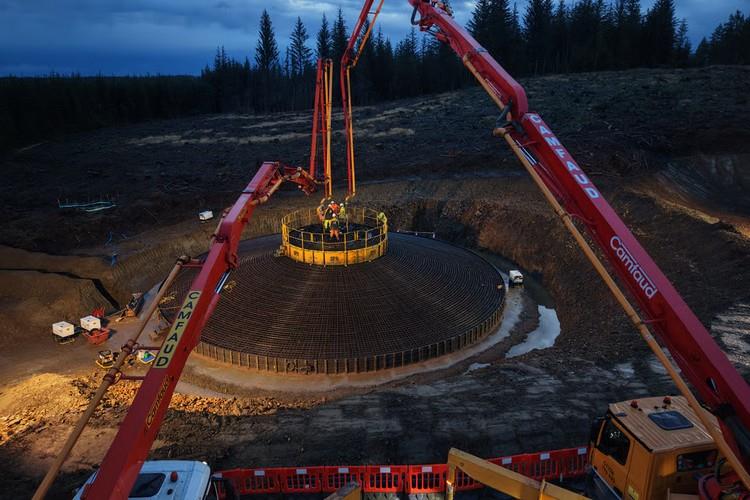

Vattenfall has completed all 14 turbine foundations at its 63MW Clashindarroch II Wind Farm in Aberdeenshire, a major construction milestone delivered in 11 weeks.

The foundations used 11,256m³ of lower-carbon concrete and approximately 1,190 tonnes of recycled reinforcing steel — equivalent to the weight of 826 cars(6). Reusing steel reduces demand for newly produced material.

The concrete contains a cement blend with at least 25% pulverised fuel ash, replacing part of the conventional Portland cement. As Portland cement is the most carbon-intensive component, the blend is expected to reduce embodied carbon by around 20–30% per cubic metre(5). Concrete was produced at a temporary on-site batching facility, reducing long-distance deliveries and the associated fuel use, traffic movements and emissions(4).

The first foundation was poured on 30 June 2026. Around 85 tonnes of reinforcing steel was used in each foundation. Construction will now move to the next phase, with first power expected in summer 2027.

Once operational, the 14-turbine wind farm is expected to have an installed capacity of 63MW3 and generate enough renewable electricity to power the equivalent of around 61,500 UK homes annually(1).

Photo - see caption
Vattenfall completes lower-carbon foundations at Clashindarroch II wind farm (Photo Credit: Vattenfall)

Stuart Matthews, Vattenfall’s Senior Project Manager for Clashindarroch II Wind Farm, said:

'Completing all 14 foundations is an important construction milestone for Clashindarroch II — and how we delivered it matters.

'Lower-carbon concrete, recycled reinforcing steel and on-site concrete production have helped us reduce embodied carbon and transport emissions during this phase.

'With the foundations complete, we can move into the next phase and continue towards first power in summer 2027.'

Bavkground

  • Clashindarroch II Wind Farm
  • 14 turbines x 4.5MW wind turbines
  • 63MW capacity
  • Equivalent UK households powered: around 61,566 annually2
  • Predicted to offset around 90,844 tonnes of CO2 every year3
  • Preparatory works commenced Autumn 2025
  • First foundation poured: 30 June 2026
  • Foundation programme duration: 11 weeks
  • Main foundation concrete: 10,136m³
  • Ducting and blinding concrete: approximately 1,120m³
  • Total concrete used: 11,256m³
  • Reinforcing steel: 1,190 tonnes
  • Around 85 tonnes of reinforcing steel per foundation
  • Parts of turbine towers also expected to use lower carbon steel(3)
  • Expected first power Summer 2027
  • Community benefit funding of around £315,000 per year
  • Find out more about Clashindarroch II wind farm here.
  1. Calculated according to RenewableUK ‘Homes Powered Equivalent’ methodology.
  2. Calculated using RenewableUK emissions displacement methodology.
  3. 63 MW Scottish wind farm to use low-emission steel in UK onshore first - Vattenfall
  4. A batching plant is a temporary, on-site facility used to mix cement. By producing cement close to where it is poured, the plant significantly reduces the need for long-distance deliveries by?road, cutting fuel use, traffic movements and associated emissions.
  5. The concrete incorporates a cement blend containing at least 25% pulverised fuel ash (PFA), replacing a proportion of Portland cement. As Portland cement is typically the most carbon-intensive constituent of concrete, the use of PFA as a supplementary cementitious material can reduce embodied carbon by approximately 20-30%, depending on the final mix design and replacement level (The Concrete Centre, 2020; Circular Ecology, 2026).
  6. Estimated weight of average car = 1440kg/1.44 tonnes. 1190/1.44 = 826.38.
    1190 tonnes recycled steel content in foundations equivalent to weight of 826 cars.

Original announcement link

Source: Vattenfall





Bookmark and Share


A global information service for upstream oil and gas opportunities - divestitures, farmins and farmouts and licensing rounds.


Subscriber Only Deals

Current Deals

Current Upstream Deals: 195

Completed Deals

Completed Upstream Deals: 6640

Company Profiles

Current Company Profiles: 2933

Corporate Activity

Current Corporate Activity articles: 4197

Companies Looking

Current number of articles: 466

Company Sales

Current Company Sales articles:1674

Geostudies

Current Geostudies articles: 1003

How to subscribe

energy-pedia Jobs

RSS Feed Widget
See all jobs...


energy-pedia Databank

The energy-pedia databank contains links to information on the world financial and energy markets, including share prices, oil and gas prices and the global stock exchanges. Read more...



energy-pedia Glossary

A list of commonly used terms in the oil and gas industry. Read more...

Subscribe

Subscribe to the FREE
energy-pedia Daily Newsletter
Subscribe

Bayphase
energy365
Borchwix
OPC
Merlin
Syntillica
Telos NRG
Rose & Assocs
About energy-pedia

energy-pedia news is a FREE news service written and edited by E and P professionals for E and P professionals.

We don't just report the news, we give you the technical background as well, with additional information derived from our unique energy-pedia opportunities service.
Contact us

energy365 Ltd

238 High Street
London Colney
St Albans
UNITED KINGDOM

Tel: +44(0)1727 822675

Email: info@energy-pedia.com
